Early Contractor Involvement

Bringing a heavy civil contractor into the project before the design is finished — how ECI works, how it converts, and when it makes sense.

01 — Definition

Early Contractor Involvement (ECI) is a method of construction contracting that lets a builder become involved — and potentially start work — before the design has been completed. SDC has used this method of project delivery in the past with success on large mixed-use and master planed developments.

Under an ECI engagement SDC is first hired for a fee covering costs associated with thier preliminary work - this can be fixed fee, costs plus or time and materials. The actual cost of construction is still unknown at that point, because the design is not final and trade pricing has not been obtained.

That is the point. The owner gets constructability review and value engineering while change is still cheap, can order long-lead items and release discrete packages, sees subcontractor pricing as it comes in, and can finish faster than a lump-sum sequence that waits on a complete set of drawings.

ECI can be construct-only, or design completion and construct. Construction Manager (CM), Managing Contractor (MC) and Guaranteed Maximum Price (GMP) are types of ECI engagement — they are not interchangeable, even though the market often treats them as synonyms. An ECI Owner/Developer-SDC agreement works well on master planned communities, multi-phased, and complex civil projects.

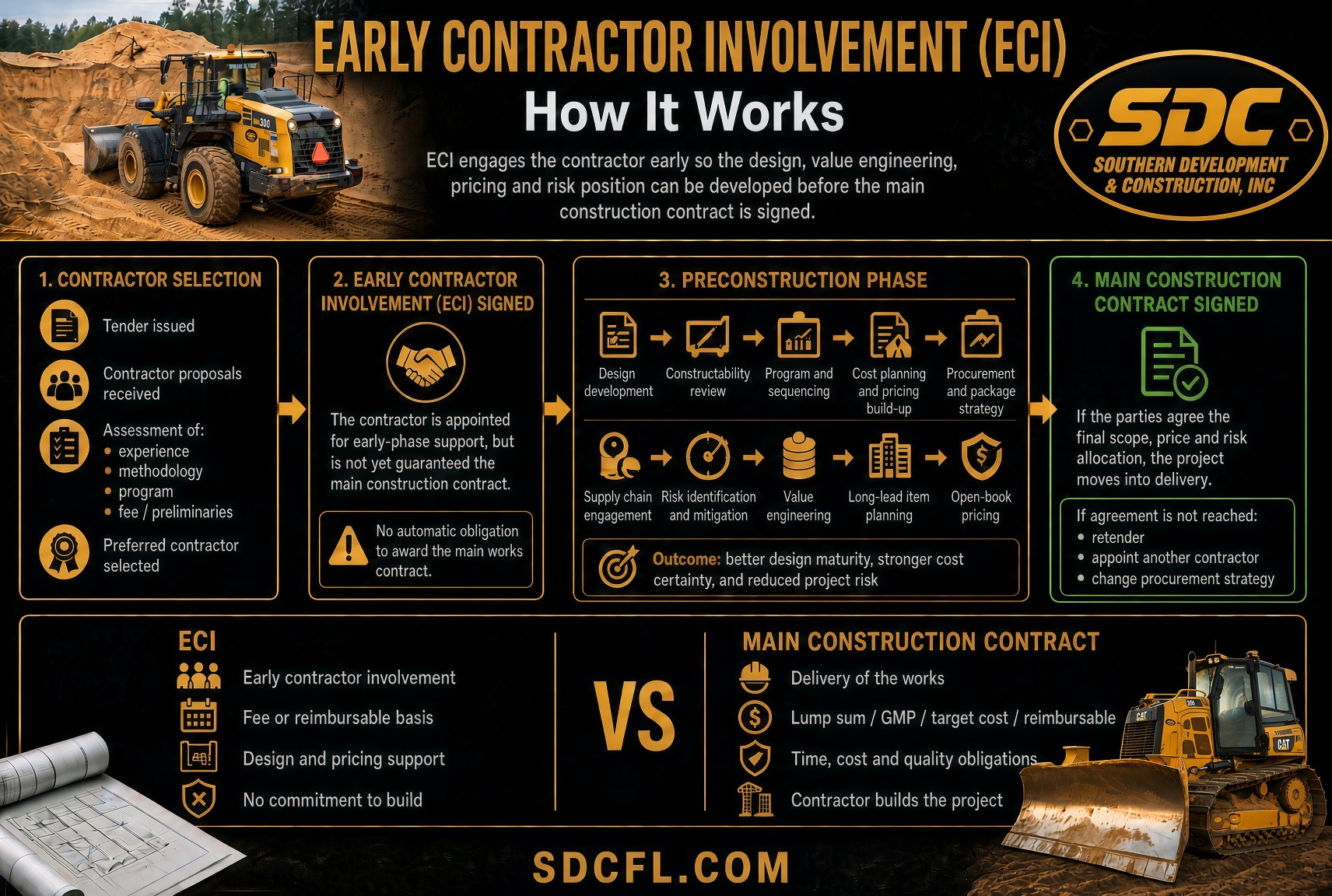

ECI — How It Works

Tap or click the diagram to enlarge it.

02 — Phase 1

Preconstruction Services

Phase 1 is a fee-based engagement agreement covering the costs associated with SDC's work. The construction cost is still unknown, because the design is not final and trade pricing has not been obtained. Below are a list of the services that can be provided by SDC and an ECI.

  • Constructability reviews
  • Value engineering
  • Earthwork balancing
  • Permitting strategy
  • Cost planning and market feedback
  • Long-lead procurement
  • Construction schedule
  • Overall development coordination

Mass earthwork optimization

Balancing cut and fill across multi-phase footprints to reduce or eliminate the need to import or export fill — a major swing cost in Florida's low-lying terrain.

Dewatering and stormwater strategy

Design feedback on master retention ponds, localized high water tables and temporary dewatering logistics.

Phasing and CDD realities

Aligning the civil construction schedule with Community Development District (CDD) bond tranches and municipal platting timelines.

Value engineering

Alternative pricing on deep sewer piping, lift stations and pavement sections based on current regional material lead times.

03 — Phase 2

Conversion to Construction

01

Exclusive negotiation

The owner stays with SDC as the site contractor. An independent cost consultant is typically engaged to test the price against the market.

02

Competitive conversion

The owner invites other proponents to bid alongside SDC, keeping competitive tension at conversion.

03

Return to market

If price cannot be agreed, the work goes to open bid and SDC withdraws from Phase 2.

Contract Models

Construction Manager (CM)

SDC acts as the owner's agent. Trade contractors are engaged by the owner; the Construction Manager is paid a fee for management and general conditions.

Managing Contractor (MC)

Trades sit under SDC, who is liable for their acts. Paid fee-plus-actual-cost, or converted to a lump sum once packages are priced.

Guaranteed Maximum Price (GMP)

Usually a Managing Contractor arrangement with a nominated ceiling. The guarantee is often not absolute — change orders and latent conditions can still adjust the price.

Construction Manager at Risk / alliance

A ceiling or target outturn cost shares overruns and savings. Useful on multi-phased work where earthwork and utilities shift between parcels.

04 — Comparison

ECI vs Traditional Lump Sum

When the contractor is engaged

ECI Concept or schematic design — and work can start before design is finished.

Traditional lump sum After design completion, usually at bid.

Role in design

ECI Active: constructability, earthwork balancing, permitting, value engineering.

Traditional lump sum Little meaningful input before bid.

Cost certainty

ECI Built through trade pricing as design matures. Lower at award than a lump sum.

Traditional lump sum Higher at award if the package is well documented.

Subcontract transparency

ECI Owner sees trade and subcontractor pricing as packages are let.

Traditional lump sum Head-contract lump sum hides most trade-level pricing.

Competitive tension

ECI At trade level, not at the head contract. Relies on the contractor behaving as a consultant.

Traditional lump sum At head-contract bid on a completed design.

Speed

ECI Long-lead items and early packages can be released before the whole design is frozen.

Traditional lump sum Construction waits on a complete, biddable set.

Best suited for

ECI Multi-phased work, master planned communities, heavy civil, interface-heavy jobs.

Traditional lump sum Straightforward projects with mature design information.

Benefits vs. Traditional (Design–Bid–Build)

Contractor entry

Traditional model After design finishes

ECI model During design

Cost predictability

Traditional model Lower (surprises cause overruns)

ECI model Higher (real-time modeling)

Change orders

Traditional model Frequent later-stage rework

ECI model Reduced via early clash detection

Schedule / time

Traditional model Sequential, siloed

ECI model ~10% faster phase completion

Cost savings

Traditional model Baseline

ECI model ~7% average reduction

Schedule and cost figures are general industry observations for ECI delivery, not results guaranteed on any specific project.

05 — Trade-offs

Advantages and Disadvantages

Advantages

Earlier constructability

A heavy civil contractor can challenge grading, haul and temporary works while the design is still cheap to change.

Value engineering

Alternatives — materials, methods, earthwork balancing — are tested before drawings are locked.

Faster start

Discrete packages and long-lead items can be released before the whole design is finalized.

Trade-level transparency

The owner sees subcontractor pricing as packages are let, rather than a single opaque lump sum.

Permitting and schedule

Permitting sequences, staging and multi-phased release can be planned with the builder in the room.

Conversion optionality

If the Phase 2 offer is not acceptable, the owner can still go back to the market.

Disadvantages

Less price certainty at award

Construction cost is unknown when the ECI contractor is first engaged, because the design is not yet priced.

Reliance on good faith

The contractor oversees subcontract bidding without competing head-contract bidders. The model assumes a consultant-like duty.

Weaker head-contract competition

Selecting one contractor early can dull bidding tension unless conversion is designed well.

Heavier administration

CM, MC and GMP are not interchangeable, and there is no single industry-standard ECI form.

GMP is often not guaranteed

Owner-directed changes and latent conditions typically still adjust a so-called maximum price.

No Phase 2 guarantee

The ECI contractor may invest in preconstruction and still not win the construction contract.

06 — Fit

When ECI Fits

Master planned communities

Multi-phased communities need a heavy civil contractor early — parcel release, shared infrastructure and earthwork balancing across the site.

Multi-phased civil work

When packages will be released over years, constructability and permitting have to be designed as a sequence, not a single bid.

Heavy civil and sitework

Earthwork, underground utilities, paving and grading benefit from value engineering before the design is frozen.

Earthwork balancing

Cut, fill, haul and stockpile strategy is cheapest to get right on paper — with the contractor who will move the dirt.

Permitting-critical jobs

Jurisdictional sequencing, environmental constraints and agency reviews can stall a lump-sum bid that arrives too late.

Complex interfaces

Constrained sites and interface-heavy work, where constructability still has to shape the drawings.

Quick Fit Check

Five questions. Answers stay in your browser — nothing is stored or sent.

  1. Is the work multi-phased, or spread across parcels released over time?

  2. Would constructability or value engineering input change the design?

  3. Is earthwork balancing, dewatering or stormwater strategy a major cost driver?

  4. Is the schedule tight enough that early packages or long-lead items matter?

  5. Are you prepared to work openly with one contractor before price is fixed?

Answer all five questions to see a result. Nothing is stored or sent.
